2024 Past Projects

Ocean View Park Pickleball Conversion (CIP No. 41016/7)

The pickleball court conversion project began on Monday, May 6, 2024, at Ocean View Park. Construction was completed in approximately 30 days and the courts were reopened on June 3, 2024.

These new pickleball courts include new nets, posts, windscreens, LED light fixtures and additional seating among other amenities. This Parks, Recreation & Open Space Master Plan project is made possible through the Proposition 68 Per Capita Grant Program and Measure M - Parks & Open Space Parcel Tax.

Project History

On June 5, 2018, California voters approved Proposition 68, the "Parks and Water Bond Act of 2018" (Senate Bill 5). Proposition 68 supports several grant programs for drought, water, parks, climate, coastal protection, and outdoor access.

The City Council adopted Resolution No. 2021-115 authorizing the submission of applications with California Department of Parks and Recreation's Office of Grants and Local Services (OGALS) on November 15, 2021, and appropriating funds from Measure M - Parks & Open Space Parcel Tax (2018) in the amount of $37,961 to be used to cover the required match for projects sited at Ocean View and Pierce Street parks. The State allocated funds to the City of Albany and disbursed funding after the grant applications were processed by OGALS in December 2021. The City received $189,805 from the Per Capita Grant Program and $250,000 from the Recreational Infrastructure Revenue Enhancement (RIRE) Grant program for local park rehabilitation, creation and improvements. The City Council adopted the Parks, Recreation & Open Space Master Plan on January 18, 2022. The Parks, Recreation & Open Space Commission reviewed the conceptual plan and project scope on September 14, 2023. PROS Commission approved the scope of work on December 14, 2023.

Check out a video of the project concept and some completion photos below!

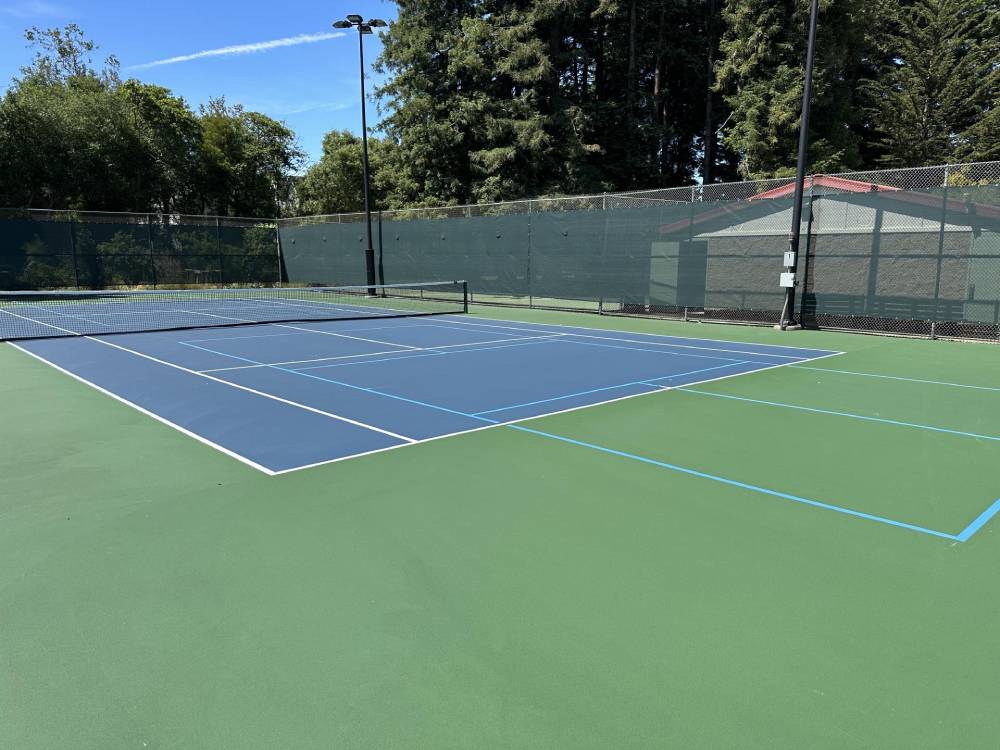

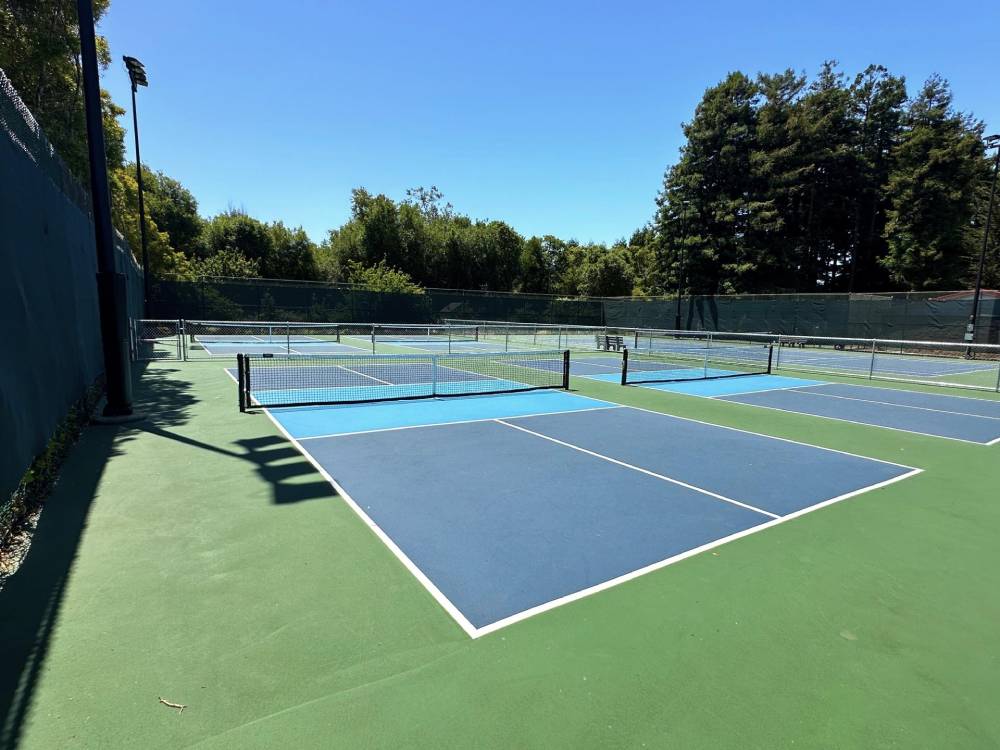

Ocean View Park Pickleball Courts
Ocean View Park Pickleball Courts

Ocean View Park Tennis Court
Ocean View Park Tennis Court

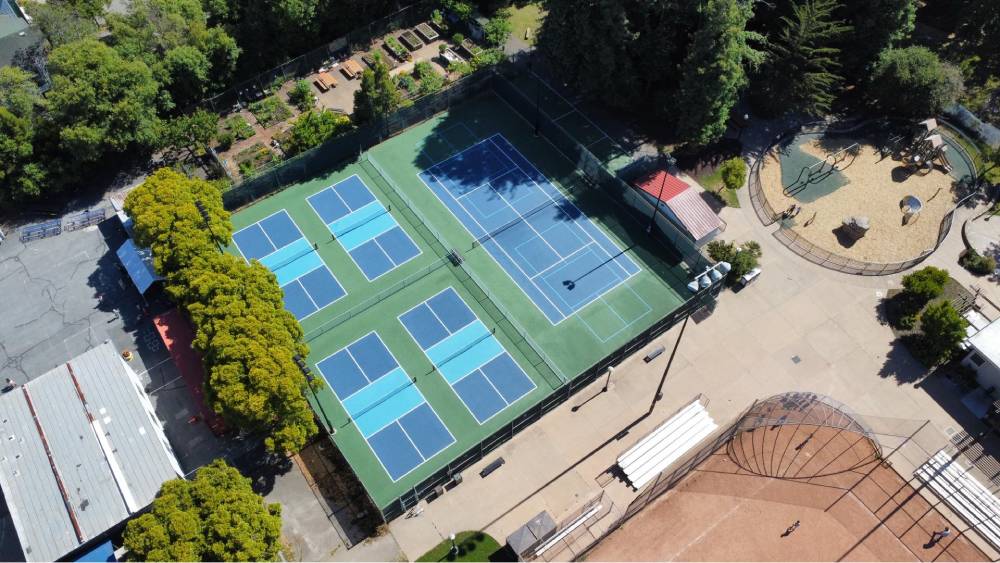

Ocean View Park Courts (Aerial View)
Ocean View Park Courts (Aerial View)

Codornices Creek Phase IV Project (CIP 43001)

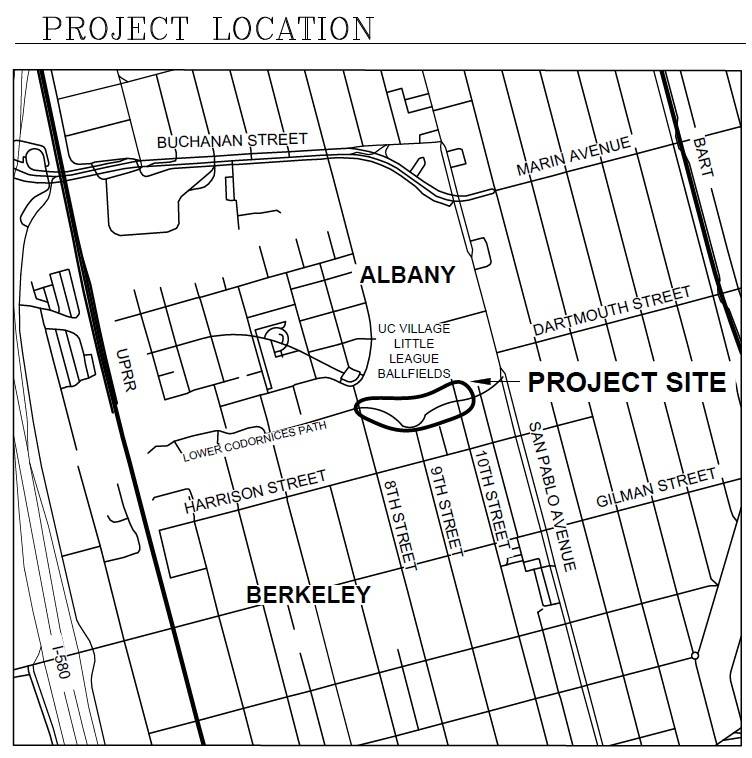

CCIV Project Map

The construction is substantially complete as of March 22, 2024 and the trail is open for users. Temporary fencing for protecting new plantings during establishment has also been taken down.

Project photos (March 2024)

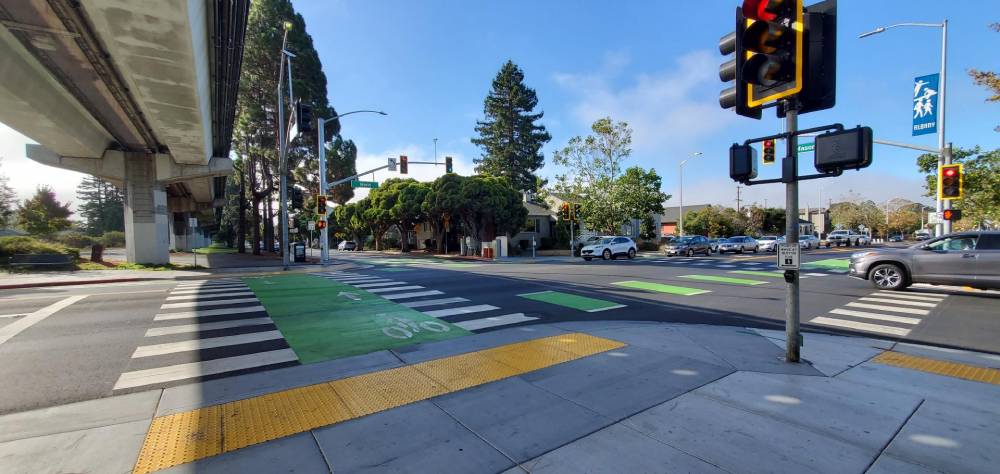

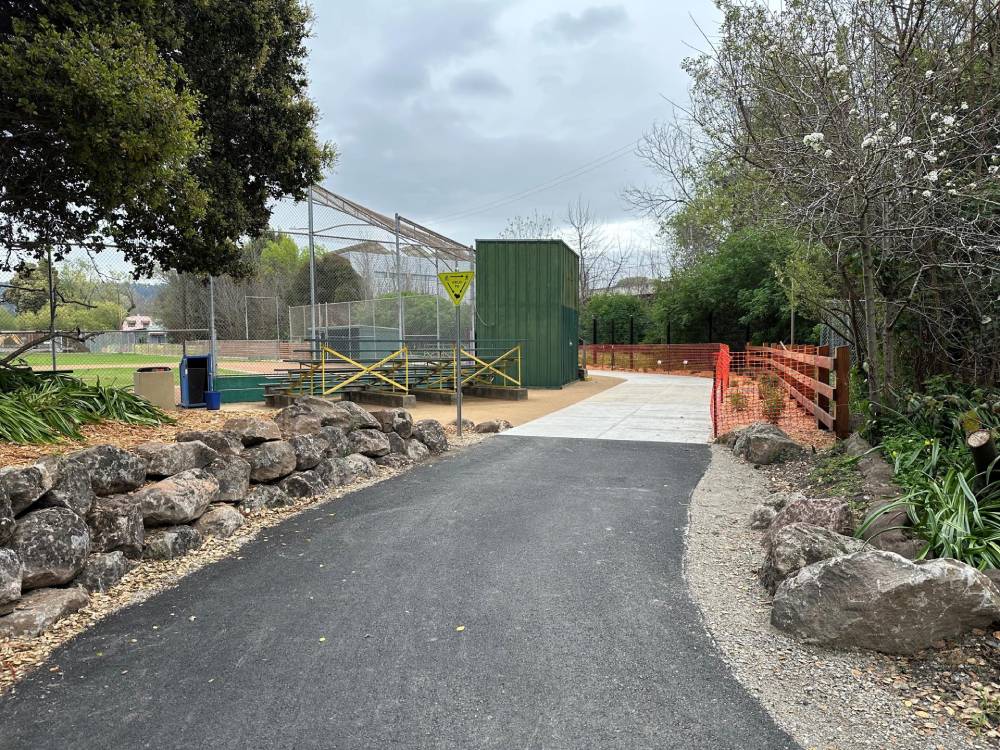

Codornices Creek Street crossing

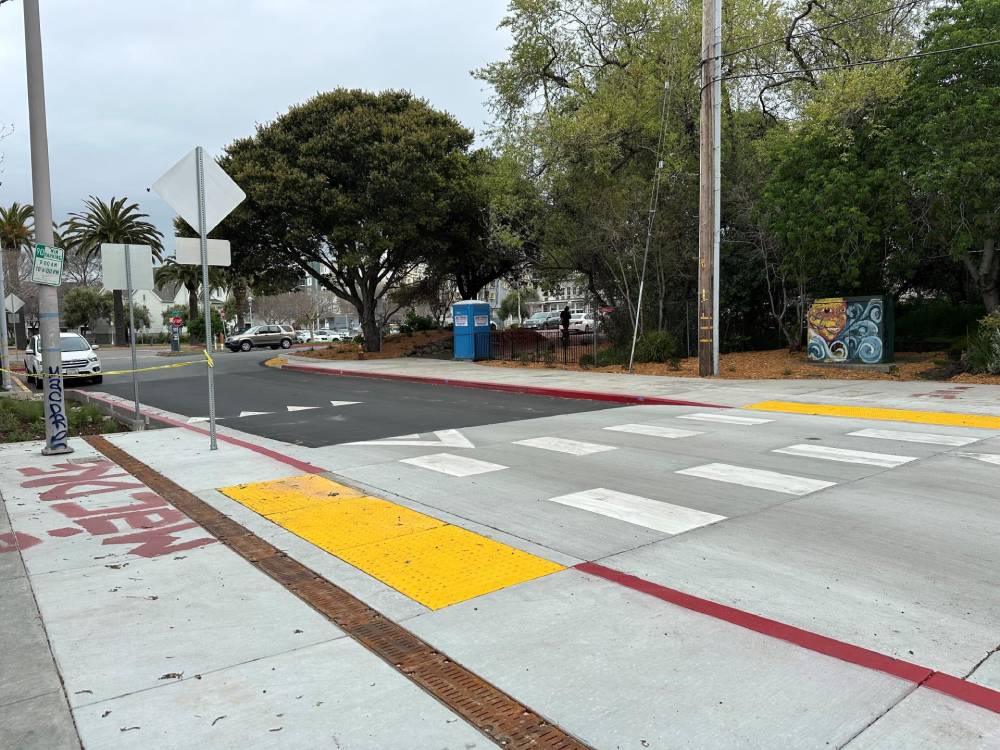

Codornices Creek Fresh pathway

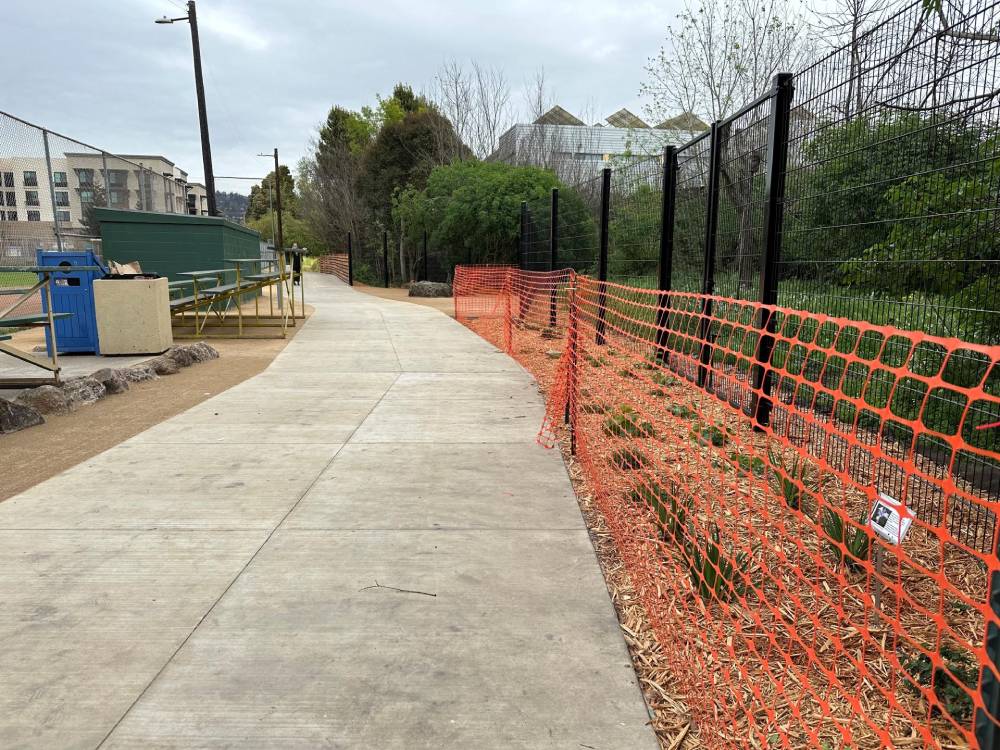

Codornices Creek Trail


Project History

The planning and implementation of the restoration of Codornices Creek between Kains Avenue to Interstate 80 has been ongoing since the late 1990s and involves the City of Albany, the City of Berkeley, and the University of California. Lower Codornices Creek forms the boundary between the cities of Berkeley and Albany and the primary owner within the Albany is the University of California (UC Village). The original master plan was prepared in 2001 and the City Council approved a Mitigated Negative Declaration in 2004, pursuant to the requirements of the California Environmental Quality Act. In addition, in 2004, the City entered into a three-way Memorandum of Understanding with the University of California and the City of Berkeley in 2004 to allow the tree agencies to work collaboratively on project to restore and maintain segments of the creek that runs from the railroad tracks on the west to San Pablo Avenue on the east.

The Lower Codornices Creek Restoration Project is an ongoing project to restore Codornices Creek from San Pablo Avenue to the western edge of UC Village. Three phases of the restoration project, from 8th Street to the railroad tracks (the western edge of UC Village), have been completed to date. As a result of earlier creek projects, native riparian habitats have been created, restoring habitat to native Steelhead Trout and improving community resilience by reducing exposure to flooding at UC Village student housing. In addition, a bicycle-pedestrian shared use trail has been constructed that connects to local and regional bicycle trail networks, and provides recreational, educational, and stewardship opportunities. In 2010, the first phases of restoration of Codornices Creek won the Association of Bay Area Governments' Growing Smarter Together Award in the category of "Protecting and Preserving the Environment" for advancing smart or "focused" growth in the Bay Area.

The Phase IV Project (CIP No. 43001) includes construction of a multi-use path from 8th Street to 10th Street to fill a gap in the multi-use path paralleling the creek. The City engaged Restoration Design Group (RDG) to design Phase IV, which was completed in 2019 and included stakeholder meetings with entities active in the project area (i.e. adjacent property owners, Ecocity Builders, Friends of Five Creeks, Albany Little League, and UC Village). Key environmental, transportation, and public works staff at the MOU Agencies provided comments and recommendations during this effort.

In June 2019, the Parks, Recreation, and Open Space Commission and the Transportation Commission recommended approval of the Project. In October 2019, the City Council accepted the Project design and authorized staff to identify funding for construction (Resolution 2019-86).

In November 2020, the City Council adopted FY2019/20-2023/24 Capital Improvement Plan(PDF, 1MB), and appropriated budget for the first three fiscal years. This included $620,000 in funds from remaining Measure R LLAD 1996-1 fund balances for the Lower Codornices Creek Restoration Project – Phase IV (CIP No. 43001).

In December 2020, the Council authorized submission of the Phase IV Project for consideration for funding as part of the Alameda County Transportation Commission's 2022 Comprehensive Investment Plan (Resolution 2021-97(PDF, 428KB)). The grant period began in July 2022.

Alameda County Transportation Commission logo

Bay Area Air Quality Management District A Healthy Breathing Environment For Every Bay Area Resident

With construction funding secured for the Phase IV Project, staff reviewed the project site in August 2022 to review potential changes as the current design was completed in October 2019. Staff observed repaving projects by UC Berkeley, habitat restoration, and tree and fence changes within the Project site since the 2019 design. Staff concluded that existing conditions had changed significantly enough to warrant an updated survey and revised plan set to reflect current conditions.

In early 2023, staff began working with original design group RDG to provide an updated plan set to reflect changes in project specifications, materials, and best practices. In addition, due to the environmental complexity with construction adjacent to a forested creek and the involvement of multiple, actively engaged stakeholders, staff worked with Zoon Engineering to provide a pre-construction review, evaluating the biddability and constructability of the Phase IV Project plan set and specifications. This pre-construction review was important for streamlining construction and providing staff more resources to manage coordination on the stakeholders' needs and requests during development of the revised plan set.

The City Council authorized a call for bids for construction of the project at the April 17, 2023 meeting (Resolution 2023-19(PDF, 1MB)).

The City Council awarded construction contracts for the project at the July 17, 2023 meeting.

Annual Sidewalk Shaving (Maintenance)

The City's Annual Sidewalk Shaving Project was completed in April 2024 within the Zone 4 of the City. A total of 2,333 sidewalk hazards were addressed during this maintenance cycle. Sidewalk shaving involves "shaving down" vertical offsets up to two inches in order to eliminate tripping hazards. This method of sidewalk improvement is an effective way to make sidewalks more accessible to all with minimal interruption to public access.

As of 2020, the City's sidewalks are divided into five Zones of similar size. The City conducts sidewalk shaving annually on one zone per year. Zone 1 was completed in 2021, Zone 2 in 2022, and Zone 3 in 2023.

Annual Sidewalk Shaving is funded as part of the City's Public Right-of-Way Maintenance Program under the Public Works Operating Budget. This program is supported by state Highway Users Tax Account (HUTA) gas tax revenue.

Annual Striping Refresh (Maintenance)

Public Works partnered with a contractor to perform minor roadway striping maintenance in April/May 2024. The work consisted of routine refresh of curb paint, traffic striping, and traffic markings, such as crosswalks and centerlines, primarily within Zone 4 and Zone 5 of the City.

As part of this work, the City also installed new red curb that restricted parking at intersections along Dartmouth Street consistent with recent state legislation (Assembly Bill 413) and City policy. For more information, check out the City's Intersection Red Curb Policy.

As of 2023, the City's roads are divided into six zones to best manage "refreshing" in a cyclical approach. Public Works plans to conduct refreshing annually on primarily two zones per year. Zone 2 and Zone 3 were refreshed in 2023.

Masonic Intersections/Ohlone Trail Safety Improvements Project (CIP 25007)

Masonic Project

The Masonic Intersections/Ohlone Trail Safety Improvements Project (CIP No. 25007) has been completed as of February 2024.

Masonic Project

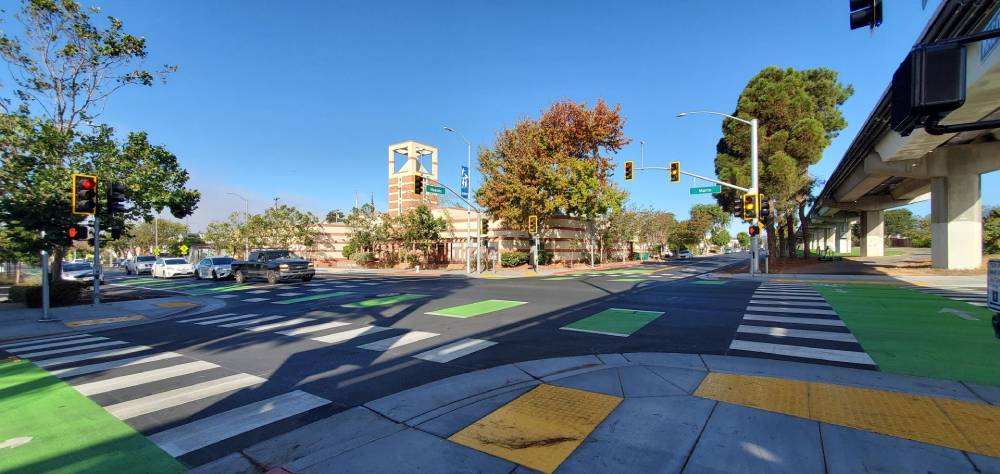

The Ohlone Greenway trail and Masonic Avenue roadway overlap at signalized intersections with two major arterials: Solano Avenue (a commercial corridor, truck route, and bus corridor) and Marin Avenue (a cross-town corridor and Class II bicycle route). These complex intersections increase the risks of conflicts between pedestrian, bicycle, and vehicular traffic. The project was intended to increase pedestrian safety by adjusting conditions at the intersection, including traffic signal upgrades, updated signal phasing, and a variety of soft and hard treatments in both key intersections. More details on improvements, as well as key milestones and other project information, are available in the Council materials linked below.

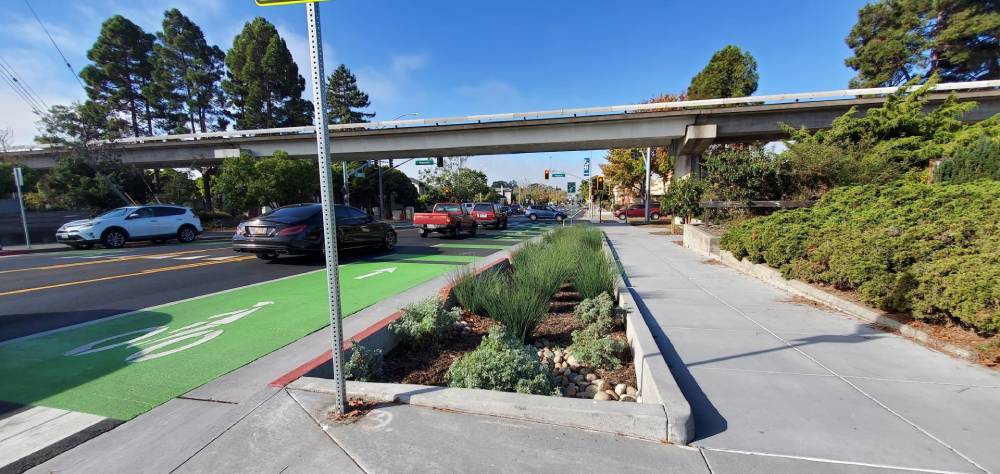

Masonic Intersections/Ohlone Trail

The project overlapped with the Marin Avenue Pavement Rehabilitation Project and was completed in tandem successfully.

Project History

Streetlighting Evaluation (CIP 25008)

In February 2024, Albany completed a Citywide Streetlighting Evaluation to better understand and plan for upgrades to the City's lighting infrastructure, which includes approximately 900 streetlights. Capital Improvement (CIP) Project No. 25008 was established to invest funds into analyzing existing lighting distribution, developing target guidelines for City streetlighting goals and objectives based on industry standards, identifying potential projects, and proposing cost scenarios for both capital improvements and programmatic maintenance requirements.

The Transportation Commission was the primary advisory body and served as a venue for public input of the draft evaluation. In addition, a website was created to gather public input and a public workshop was hosted in September 2023. The draft evaluation was presented to the City Council in February 2024, where Council accepted the streetlighting guidelines and near-term recommendations.

For more information, check out the Citywide Streetlighting Evaluation page to access a recording of the public workshop, Transportation Commission or City Council presentations, and the reports prepared under this project.
